The most common question we hear at consultations is never about price.
It is always about the schedule.
How long does a kitchen renovation take? Toronto homeowners want to know exactly when they will lose access to their cooking space. We see this anxiety every single day, and the lack of clarity in the industry is the main reason why.
Let’s look at the actual data, break down what causes delays, and explore the exact kitchen renovation timeline Toronto homeowners can expect.
The full project at a glance
A typical full Toronto kitchen renovation runs roughly 12 to 16 weeks from the moment you sign the contract to the final walkthrough.
The on-site disruption window is much shorter than most people expect. We aim to limit active construction in your home to a focused 4 to 8 week period.
The rest of the timeline is dedicated to planning, sourcing, and fabrication.
| Phase | Duration | Core Activity |
|---|---|---|
| Weeks 1-2 | 1 to 3 weeks | Design finalization, material selection, contract signing. |
| Weeks 3-4 | 2 to 4 weeks | Permit filing and condo board approvals. |
| Weeks 5-10 | 4 to 8 weeks | Cabinet shop fabrication and finishing. |
| Weeks 8-10 | 1 to 2 weeks | Demolition and rough-in. |
| Weeks 10-14 | 2 to 4 weeks | Cabinet install, counters, tile, fixtures, finishing. |
| Week 14-16 | 1 week | Final walkthrough and deficiency resolution. |
Phase 1: In-home consultation and design (1-3 weeks)
This initial planning and discovery stage takes 1 to 3 weeks for most clients. We visit your home to take precise measurements, document the existing mechanicals, and photograph the space.
The goal is to establish a firm direction for the layout and material selections. Two rounds of design revisions are usually standard before the final sign-off.
If you already have a firm design direction, this phase moves much faster. We strongly recommend having your appliance specifications finalized right now, as specific fridge and stove dimensions dictate the entire cabinet layout.
Condo design requirements
Condo owners face additional steps during this first phase.
We must check your building’s alteration agreement to see exactly what the board allows. Elevator dimensions, quiet hours, and electrical panel capacity all need to be documented early to prevent costly delays.
Phase 2: Contract and permits (1-4 weeks)
We issue a detailed, fixed-price contract once the design is approved. The contract and permit phase generally spans 1 to 4 weeks depending on municipal processing times.
This document covers labour, materials, cleanup, disposal, and a phase-by-phase calendar.
If your scope triggers a Toronto Building permit, the wait time depends heavily on the scope of the job. According to Toronto Building processing targets, their Express Services stream typically processes complete applications for simple interior alterations in 10 to 15 business days.
We always start ordering long-lead materials and begin cabinet fabrication in parallel, so the permit review does not freeze the entire schedule.
When permits take longer
Major structural changes or additions require a standard permit review, which currently takes 4 to 8 weeks in Toronto.
City data shows that if your proposed design requires a Minor Variance through the Committee of Adjustment, you must add 3 to 4 months to your timeline for the hearing and processing.
Phase 3: Cabinet fabrication (4-6 weeks)
Custom cabinets built in local Toronto shops typically require 4 to 6 weeks from the initial material order to the final finishing coat. Cabinet manufacturing is almost always the longest single stretch of the project.
We manage this step off-site, meaning no active construction happens inside your home yet.
Specialty finishes can significantly extend this window. Elements that push lead times to 8 or even 12 weeks include:
- Solid wood doors
- Hand-applied multi-step lacquers
- Exotic veneers
- Custom stain matching
We lock in these orders immediately after contract signing to keep the rest of the project on track.
Phase 4: Demolition and rough-in (1-2 weeks)
Demolition and rough-in usually wrap up in 1 to 2 weeks. This is when the on-site disruption officially begins, as we carefully remove your old kitchen.
Our team protects your floors and adjacent rooms with heavy-duty barriers before work starts. The rough-in trades then take over to ensure steady progress.
The rough-in sequence typically includes:
- Plumbing: Relocating drains and supply lines for new sink or dishwasher positions.
- Electrical: Adding new dedicated circuits, GFCI outlets, and lighting feeds.
- HVAC: Modifying ductwork for new range hood venting.
- Drywall: Patching and boarding any altered walls.
- Inspections: Passing the required Electrical Safety Authority (ESA) and municipal checks.
We carefully sequence the trades to minimize the number of people inside your home at any given time.
Phase 5: Install and finishing (2-3 weeks)
The final installation and finishing sequence takes exactly 2 to 3 weeks to complete. The base and upper cabinet boxes go in first, followed by the doors, drawer fronts, and hardware.
We template the countertops only after the base cabinets are perfectly level and secured.
Quartz or natural stone fabricators typically need 1 to 2 weeks to cut and polish the counters after the templating visit. Once the counters are installed, the final trades return to complete the space.
This finishing sequence includes:
- Installing the tile backsplash and grouting.
- Connecting the sink, faucet, and dishwasher.
- Installing light fixtures and under-cabinet lighting.
- Painting the walls, ceiling, and trim.
Your kitchen takes shape rapidly during this stage.
We send you daily site updates with photos so you can track the progress without having to be there.
Phase 6: Walkthrough and warranty (a few days)
The final walkthrough and warranty registration takes just a few days to finalize. We look for misaligned drawers, chipped tile edges, or missing pieces of toe-kick trim to resolve before closing the project.
The goal is to fix every single minor item on the spot or schedule the adjustment within a few days. Your project officially concludes when you are completely satisfied.
The 10-year cabinet craftsmanship warranty and the 2-year installation warranty are then registered in your name.
What extends timelines
Three specific factors derail more renovation schedules than anything else: condo board approvals, custom material lead times, and structural surprises behind the walls.
- Condo board approvals: In Toronto, condo boards can take anywhere from 2 to 6 weeks to review and approve a renovation agreement.
- Custom material lead times: Hand-glazed tiles from boutique suppliers or specialty European appliances often take months to arrive.
- Surprises behind the walls: Uncovering knob and tube wiring, water damage, or hidden asbestos is extremely common in pre-1980 homes in neighbourhoods like The Annex or Riverdale.
We build a small contingency window into every contract to handle these typical Toronto surprises.
Knob and tube wiring, for example, must be completely upgraded to copper to pass ESA standards and maintain your home insurance. By planning for the unexpected, we keep your stress levels low.
We give you a phase-by-phase toronto kitchen reno timeline in your contract and update it every Friday with photos and progress notes. See how the process works or request a free in-home estimate to get a project-specific timeline for your kitchen.

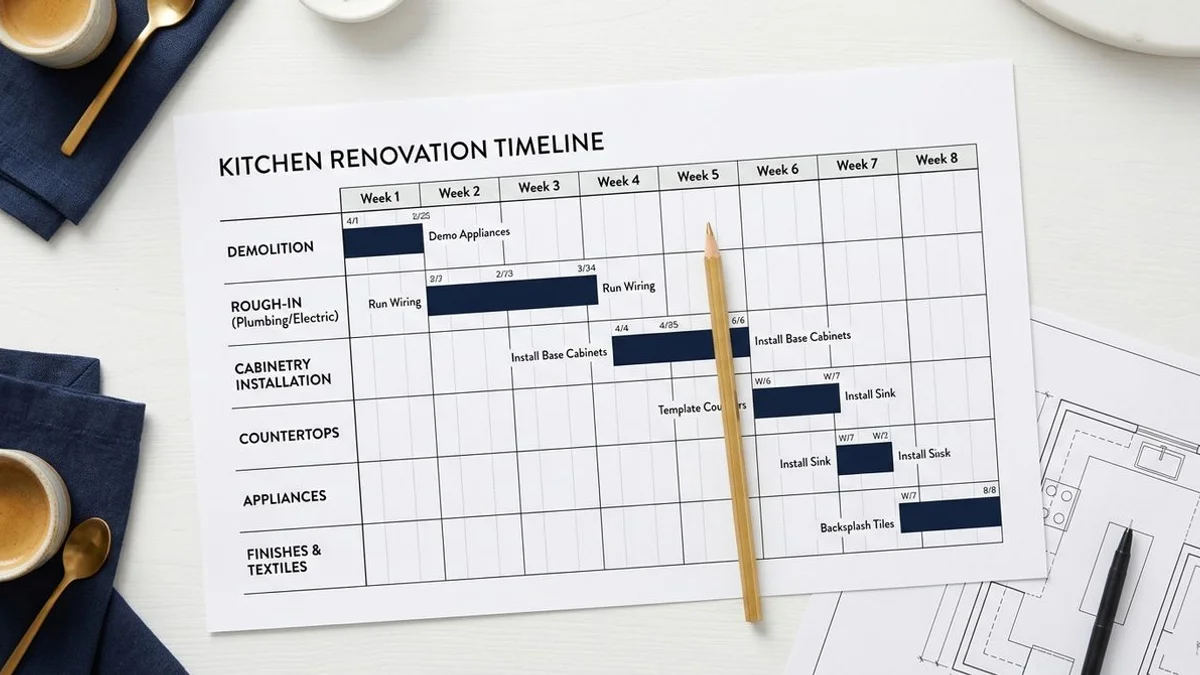

Week-by-week Toronto kitchen renovation timeline chart
