We often see homeowners brace for endless delays when upgrading their homes. Kitchen projects definitely earn that reputation, but bathroom updates usually move much faster.
Our team attributes this speed to a smaller footprint, fewer trades, and shorter cabinet lead times.
A predictable bathroom renovation timeline emerges from the first measurement to the final coat of paint. We have tracked the exact schedule for hundreds of local projects.
”Knowing exactly what happens on day three versus day thirteen transforms a stressful project into a smooth process.”
Our project managers use this realistic phase-by-phase schedule for every full Toronto renovation.
Total project timeline
A full Toronto bathroom renovation takes exactly 4 to 8 weeks from contract signing to the final walkthrough. We divide every job into two distinct parts to keep the schedule organized.
The pre-construction phase happens quietly in supplier facilities and our shop. Our clients appreciate knowing exactly when the on-site noise will start.
City data from 2026 shows Toronto building permits for simple interior work take about 10 to 15 business days.
| Phase | Typical Duration | Key Activities |
|---|---|---|
| Pre-construction | 2 to 4 weeks | Design, contracts, permits, material orders |
| On-site construction | 2 to 4 weeks | Demolition, rough-in, tile, fixtures |
| Total project | 4 to 8 weeks | Contract signing to final walkthrough |
Delays in custom material shipping across Canada can easily push this schedule out by a month. We build buffer time into the plan to account for these logistical hurdles.
Phase 1 - Design and quote (Days 1-7)
This initial planning and design phase requires 5 to 10 days to complete. We begin with a free in-home consultation to measure the space and photograph existing conditions.
Identifying plumbing or structural triggers early prevents expensive surprises later. Our designers use 2020 Design Live software to build accurate 3D renderings.
This technology lets you visualize the exact layout before a single hammer swings. We include several key documents to guarantee complete transparency.
- 2-3 layout options (if the layout is changing).
- Material schedule (tile, fixtures, vanity, lighting).
- Fixed-price contract.
- Project timeline.
Clients receive this comprehensive package within one week of the initial visit. We handle all revisions quickly to lock in the fixed-price contract.
Phase 2 - Permits and ordering (Days 7-14)
Securing a Toronto building permit for bathroom-scope work takes 2 to 4 weeks. We file the application immediately to prevent unnecessary delays.
Plumbing relocations, electrical work, and structural changes always trigger this municipal requirement. Our team calculates permit fees based on the 2026 Toronto fee schedule.
Minor plumbing permits usually cost around $200, while major structural fees run $18.56 per square meter. We start ordering everything from tiles to faucets the moment the contract is signed.
| Material | Sourcing | Typical Lead Time |
|---|---|---|
| In-stock tile | Local GTA distributors | 1 to 2 weeks |
| Custom or imported tile | European suppliers | 4 to 8 weeks |
| Standard fixtures | Plumbing suppliers | 1 to 3 weeks |
| Custom vanities | Canadian manufacturers | 4 to 6 weeks |
Fabricators measure glass shower enclosures after the tile is installed, which takes 2 to 3 weeks for production. We handle all logistical tracking so you never have to chase a delivery truck.
This entire phase compresses to just a few days for cosmetic-only updates that do not require permits.
Phase 3 - Demolition (Days 1-3 of on-site)
Demolition takes 1 to 2 days for cosmetic changes and up to 3 days for a full tear-out. We strip the room down to the studs to expose any hidden water damage.
Safety regulations dictate how this phase unfolds in older properties. Our crews mandate a Designated Substance Survey for any Toronto home built before 1990.
Ontario Regulation 278/05 requires this testing because asbestos often hides in old vinyl floor tiles or drywall joint compound. We set up negative air pressure systems and HEPA filters before removing any debris.
The crew safely hauls away several core components:
- All fixtures (toilet, vanity, sink, shower or tub).
- Wall tile and substrate.
- Floor tile and underlayment.
- Sometimes ceiling drywall (if recessed lighting or fan changes).
- Always: anything water-damaged behind tile or under fixtures.
We schedule specialized disposal bins to keep your driveway clear. Tearing out the old bathroom is definitely the messiest part of the process.
Phase 4 - Plumbing and electrical rough-in (Days 3-6)
The plumbing and electrical rough-in phase takes 2 to 3 days for a standard scope. We coordinate licensed trades to install the essential infrastructure behind the walls.
The plumbing rough-in includes new lines for relocated fixtures, valve roughs for the shower, water shut-offs, and drain modifications. Our plumbers map out these connections to ensure perfect alignment with your chosen fixtures.
Moving plumbing across the bathroom adds another one to two days to the standard schedule. We run new electrical circuits to support heated floors, GFCI outlets, exhaust fans, and upgraded lighting.
Upgrading the bathroom to a dedicated 20-amp circuit is now standard practice to prevent tripped breakers. We arrange for an Ontario Electrical Safety Authority inspection before closing up the walls.
”Passing these municipal inspections is mandatory if permits were required. Every new wire and pipe must be verified before the drywall goes up.”

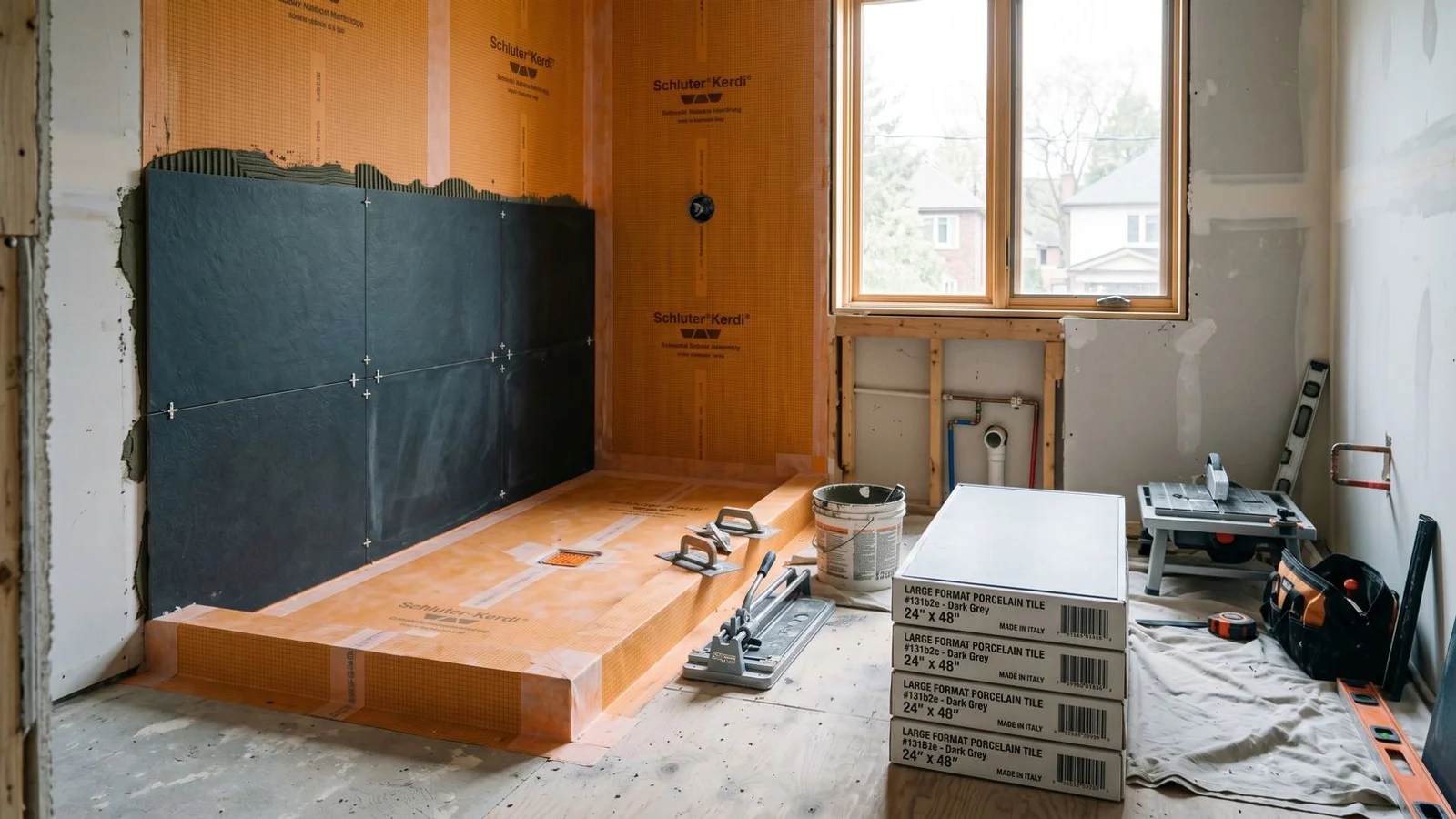

Phase 5 - Waterproofing (Days 6-9)
Waterproofing requires a strict 48-hour cure time before any tile installation can begin. We consider this the most critical step to prevent leaks five to ten years post-renovation.
Toronto building code strictly requires proper waterproofing in all wet areas. Our default approach includes several specific components:
- Schluter Kerdi membrane on shower walls.
- Kerdi-Drain for the shower drain.
- Foam shower pan board instead of a mortar bed.
- 48-hour cure time before tile installation.
Foam boards are significantly faster to install, drier, and dimensionally more stable. We completely avoid rushing the chemical bonding process.
Using the wrong mortar chemistry creates hidden failures. Our installers use unmodified thin-set meeting ANSI A118.1 standards to attach the Kerdi membrane.
Using a modified thin-set between impervious layers can take 14 to 60 days to dry, trapping moisture behind your walls. We verify every seam is perfectly sealed with Kerdi-Fix, which cures fully in 24 hours.
Phase 6 - Tile installation (Days 9-15)
A full-bathroom tile installation runs 5 to 8 working days. We follow a specific sequence to guarantee flawless lines and proper drainage.
Here is the standard order of operations:
- Floor tile first (or last, depending on the approach).
- Wall tile (shower, vanity backsplash if applicable).
- Niches and accents.
- Grouting, typically 24 hours after tile install.
- Sealing, for natural stone or porous tile.
Our installers use premium mortars like Mapei Adesilex to secure large-format porcelain or natural stone. Using a mechanical tile leveling system prevents uneven edges on large 24x48 inch tiles.
We follow up by sealing any natural stone to protect against stains. Complex designs naturally require more time and precision.
Our team adjusts the schedule when working with custom patterns, hexagonal tiles, or small-format mosaics. These intricate choices extend the timeline substantially.
Phase 7 - Fixture install (Days 15-18)
Installing the final fixtures and connecting the plumbing takes about three days. We install the primary components in a very specific order to protect the new finishes:
- Toilet, vanity, sink, installed after floor tile is sealed.
- Shower fixtures, including the handle, head, and valve, connected and tested.
- Faucets, installed and connected.
- Mirror, lighting, accessories.
- Glass shower enclosure, measured, fabricated, then installed.
Water efficiency is a major factor in modern component selection. Our plumbers install high-efficiency toilets that meet the Ontario Building Code maximum of 4.8 Litres Per Flush.
Faucets are then mounted and fully pressure-tested to check for slow drips. We ensure the two to three weeks of total glass shop time overlaps with the tile installation.
Local GTA custom glass fabricators need 5 to 10 days to cut and temper panels after measuring the finished tile. Our project managers verify the glass is ready to install by the time the tile work wraps up.
Phase 8 - Finishing and walkthrough (Days 18-21)
Painting, caulking, and the final walkthrough require the last three days of the project. We run through a strict completion checklist to wrap up the site:
- Paint and trim.
- Final caulking around fixtures.
- Hardware, including towel bars, toilet paper holders, and robe hooks.
- Final cleanup.
- Walkthrough with the client for a deficiency review.
Mildew-resistant paint, like Benjamin Moore Aura Bath & Spa, protects the drywall from daily humidity. Our team uses high-grade 100% silicone caulking that requires a full 24 hours to cure before you can use the shower.
A comprehensive cleanup removes all construction dust before the final inspection. We conduct a final walkthrough with you to review every single detail.
Any identified deficiencies are documented and resolved on the spot. Our crew schedules any remaining touch-ups within the same week.
What can extend the timeline
Custom tiles, structural changes, and backordered fixtures are the most common reasons a timeline extends. We identify these risks early to give you realistic expectations.
Here are the specific factors that delay a project:
- Custom tile patterns or small-format mosaics: Add 3 to 7 days to install.
- Heated floor systems: Require additional dry time between thinset coats and ESA electrical certification. Add 2 to 3 days.
- Wall removal or structural change: Adds 3 to 5 days for engineer review, demolition, framing, and inspection.
- Plumbing relocation across the bathroom: Can add 1 to 2 weeks if it triggers permit waits or requires coring through concrete.
- Backordered fixtures: The project pauses if a critical fixture, like a toilet or faucet, fails to arrive on time.
- Asbestos discovery: Finding materials like Zonolite vermiculite requires certified Type 2 or Type 3 abatement, pausing work for 1 to 2 weeks.
Our purchasing strategy minimizes supply chain risks significantly. Over-ordering during the planning phase keeps backordered fixtures from stalling the job.
What we do during the timeline
Our team provides daily site updates and weekly milestone reports throughout the entire project. We use project management software like Buildertrend to share photos and keep you informed.
Consistent communication provides several key benefits:
- Removes the stress of living in a construction zone.
- Keeps you informed on the broader schedule.
- Creates a permanent record of what is behind the walls.
Our commitment extends long after the final walkthrough and deficiency resolution. A comprehensive two-year installation warranty is registered directly in your name to protect against water penetration.
We want you to feel completely confident in your new space. Understanding the complete bathroom renovation timeline makes getting started much easier.
Our team is ready to help you plan the perfect upgrade. Browse our bathroom renovation service, see small bathroom design ideas for Toronto homes, or book a free in-home consultation to scope your project.
Week-by-week bathroom renovation timeline chart
